Mersin|AEM Technology|Akkuyu Nuclear|AtomEnergoMash|Atomenergoremont|Atomtechenergo|GE Steam Power|General Electric|Inter RAO UES|NIKIMT-Atomstroy|Nukem Technologies|Rosatom State|Rosenergoatom|Rusatom Energy International|Titan2 Ic İçtaş İnşaat|Tyazhmash|ZiO–Podolsk Plant|Türkiye|Akkuyu Nuclear Power Plant|Nuclear Power
||||
mersin|aem-technology|akkuyu-nuclear|atomenergomash|atomenergoremont|atomtechenergo|ge-steam-power|general-electric|inter-rao-ues|nikimt-atomstroy|nukem-technologies|rosatom-state|rosenergoatom|rusatom-energy-international|titan2-ic-ta-naat|tyazhmash|ziopodolsk-plant|trkiye|akkuyu-nuclear-power-plant|nuclear-power

Akkuyu nuclear power plant project, Türkiye – update

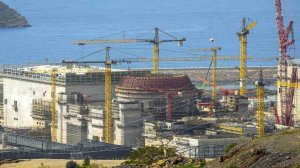

Akkuyu Nuclear NPP under construction

Akkuyu Nuclear has fulfilled all the requirements of Turkish legislation and international standards for the start of precommissioning works at the Unit 2.

Photo by Akkuyu Nuclear

15th May 2026

By: Sheila Barradas

Creamer Media Research Coordinator & Senior Deputy Editor



Font size: - +

Name of the Project
Akkuyu nuclear power plant (NPP) project.

Location
Mersin, Türkiye.

Project Owner/s
Akkuyu Nuclear, comprising Inter RAO UES JSC, Rosenergoatom JSC, Atomtechenergo JSC, Atomenergoremont JSC and Rusatom Energy International JSC.

Project Description
The Akkuyu NPP will be based on an NPP-2006 serial project. The 4 800 MWe plant will comprise four VVER1200 reactors and is expected to meet about 10% of Türkiye’s electricity needs.

The power unit includes a reactor plant and a turbine plant.

The primary circuit is radioactive and comprises a reactor, four reactor coolant loops, four reactor coolant pumps, heating parts of four steam generators and one steam pressuriser.

The secondary circuit is not radioactive. It comprises steam generators; fresh steam conduits; one turbine unit comprising a turbine plant and a turbine generator; condensate pumps; a system of low-pressure regenerative heaters; a turbine condensate system; deaerators; a feedwater system, including feedwater pumps; and a system of high-pressure regenerative heaters.

The turbine is equipped with a condensing unit and regenerative installation for heating the feedwater and separators, with unregulated steam extraction for the NPP’s auxiliary needs and heating chemically treated water additives in the circuit.

Capital Expenditure
The project is estimated at $20-billion.

Planned Start/End Date
The aim is for the first unit of the plant to start supplying Türkiye's energy system in 2025, and for all four units to be operational by the end of 2028.

Latest Developments
The Council of the Nuclear Regulatory Authority (NDK) of Türkiye has granted Akkuyu Nuclear a permit for the precommissioning stage works at Akkuyu NPP Unit 2.

The application documents for the permit were submitted to the NDK in May 2025. As part of the application, Akkuyu Nuclear submitted a set of documents with a detailed description of the commissioning stages of the unit, pertaining to technological operations and the process of operational personnel training. The total amount of documentation exceeded 22 000 pages.

Following the review of the application, the Council of the Nuclear Regulatory Authority decided to issue a ‘Permit for precommissioning stage works at Akkuyu NPP Unit 2’. The document establishes the procedure for interaction with NDK at the upcoming stage of startup and adjustment works. All operations are subject to supervision and approval by the supervisory authority.

Key Contracts, Suppliers and Consultants
Rosatom State Corporation (construction of VVER-1200 reactors under a build, own, operate model); Titan2 Ic İçtaş İnşaat Anonim Şirketİ (construction contractor); GE Steam Power and AEM Technology, a joint venture between AtomEnergoMash and General Electric, or GE (design and supply of the equipment and systems for the whole conventional island); JSC Tyazhmash (core melt trap); and Nukem Technologies and NIKIMT-Atomstroy JSC (supply of the equipment for compacting solid radioactive waste); and ZiO–Podolsk Plant, which is part of Rosatom’s machine building division (equipment manufacturer).

Contact Details for Project Information
Akkuyu NPP JSC, tel +90 312 442 60 00, fax +90 312 442 60 16 or email info@akkuyu.com.





Edited by Creamer Media Reporter

Article Enquiry

Email Article

Save Article

To advertise email advertising@creamermedia.co.za or click here

Showroom

Multotec
Multotec

Multotec, recognised industry leaders in metallurgy and process engineering help mining houses across the world process minerals more efficiently,...

VISIT SHOWROOM
Monitor Distributors
Monitor Distributors

We at Hawk High Pressure Pumps specialise in industrial pumps and pumping systems. Our high pressure washing equipment is locally manufactured and...

VISIT SHOWROOM

Latest Multimedia

sponsored by

Option 1 (equivalent of R125 a month):

Receive a weekly copy of Creamer Media's Engineering News & Mining Weekly magazine
(print copy for those in South Africa and e-magazine for those outside of South Africa)
Receive daily email newsletters
Access to full search results
Access archive of magazine back copies
Access to Projects in Progress
Access to ONE Research Report of your choice in PDF format

Option 2 (equivalent of R375 a month):

All benefits from Option 1
PLUS
Access to Creamer Media's Research Channel Africa for ALL Research Reports, in PDF format, on various industrial and mining sectors including Electricity; Water; Energy Transition; Hydrogen; Roads, Rail and Ports; Coal; Gold; Platinum; Battery Metals; etc.

Already a subscriber?

Forgotten your password?

MAGAZINE & ONLINE

SUBSCRIBE

RESEARCH CHANNEL AFRICA

SUBSCRIBE

CORPORATE PACKAGES

CLICK FOR A QUOTATION







301

sq:0.085 1.023s - 155pq - 2rq
Subscribe Now
